Construction Claims • EOT • Forensic Delay Analysis

Force Majeure and Extension of Time Claims Amid the 2026 Gulf Conflict: A Practical Guide for Contractors in the UAE, Qatar and Saudi Arabia

Since hostilities in the Gulf began on 28 February 2026, contractors, employers and consultants across the region have been forced to confront a question that most FIDIC and bespoke construction contracts were never really drafted for: what happens to time and cost entitlement when the disruption isn't a design change or a weather event, but a regional conflict affecting shipping lanes, insurance markets, air travel and labour mobility all at once?

This guide sets out, in practical terms, how contractors and employers in the UAE, Qatar and Saudi Arabia should be thinking about force majeure, extension of time (EOT) entitlement, and forensic delay analysis in the current environment — and where the evidentiary and procedural pitfalls lie.

The scale of the disruption

The conflict's effect on the Gulf construction sector has been real, but uneven — and the data so far tells a story of resilience under strain rather than collapse.

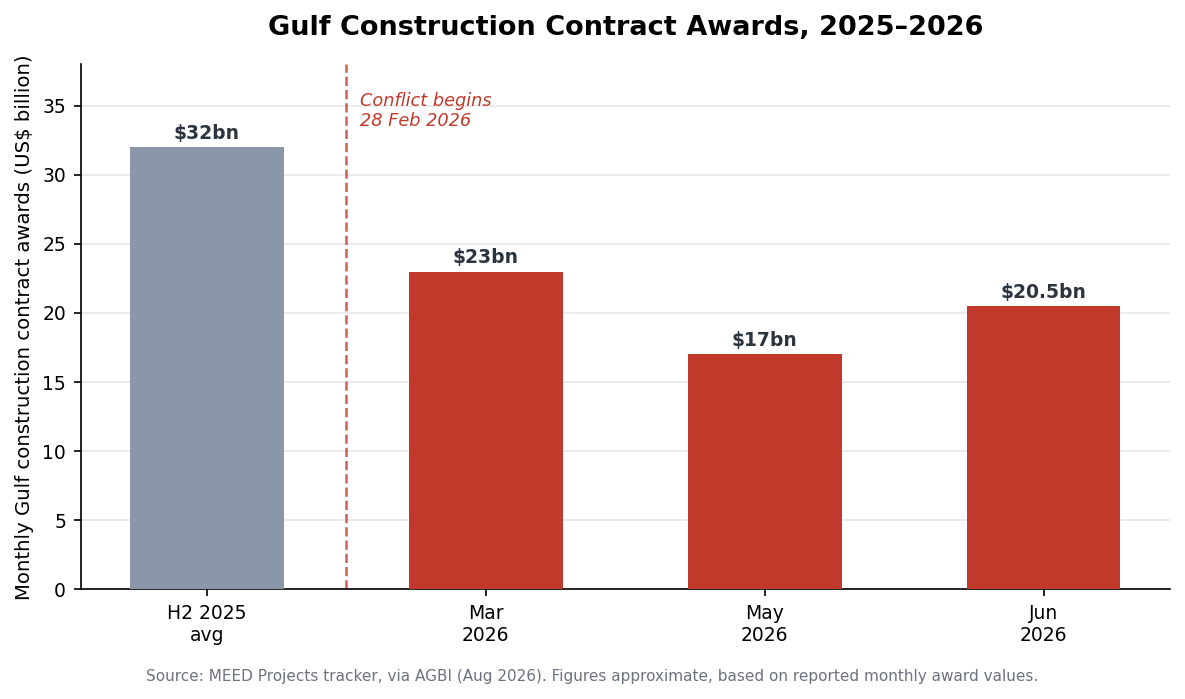

Gulf construction contract awards, 2025-2026
Gulf construction contract awards, 2025-2026

Monthly Gulf-wide contract award values, tracked by MEED Projects, averaged around $32 billion in the second half of 2025. Following the conflict's onset, awards fell to $23 billion in March, dropped further to $17 billion in May, and partially recovered to $20.5 billion in June — still roughly a third below the prior year's pace. Qatar has been the clearest laggard: after one large contract pushed February awards to $8.5 billion, monthly values stayed under $50 million for three straight months. The UAE and Saudi Arabia have fared comparatively better, with Saudi awards more than quadrupling year-on-year in June even as the broader region slowed.

Behind the headline award figures sits a deeper cost story. The Strait of Hormuz, which carries roughly a fifth of global oil and LNG trade, has seen sharply reduced vessel traffic amid security concerns and rising war-risk insurance premiums — at points compounded by statements from Iran's Revolutionary Guard signalling the strait was effectively closed to shipping. Even without a formal closure, carriers have rerouted or delayed sailings, and industry estimates suggest shipping rates on affected routes could rise 50–80% if conditions persist.

That is feeding directly into tender and building costs.

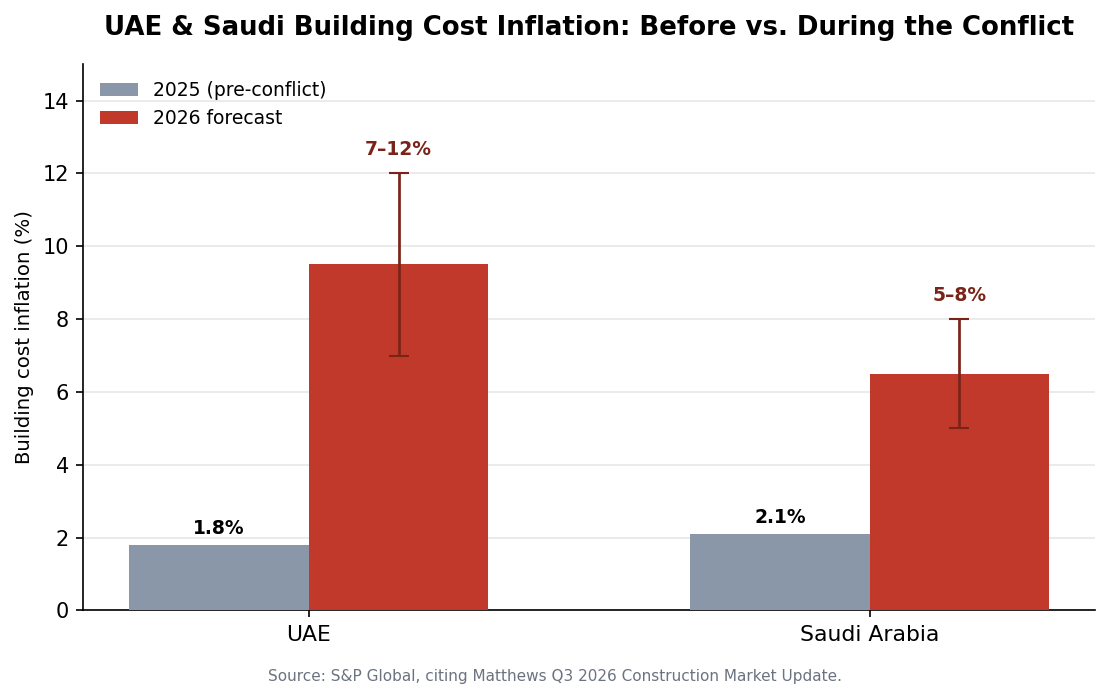

UAE and Saudi building cost inflation, 2025 vs 2026
UAE and Saudi building cost inflation, 2025 vs 2026

Matthews' Q3 2026 Construction Market Update, cited by S&P Global, forecasts UAE building cost inflation of 7–12% in 2026, up from just 1.8% the year before — driven by fuel, freight and insurance costs feeding through into contractor pricing. Saudi Arabia's forecast range is 5–8%, up from 2.1%. Periodic airspace closures and flight suspensions have also disrupted the mobile expatriate workforce the GCC construction sector depends on, from site engineers to specialist technicians.

Crucially, most contractors report that the majority of sites have continued operating without disruption — a minority of projects have paused, generally at the request of authorities or because of proximity to strategically sensitive locations. This matters for claims purposes: entitlement has to be assessed project-by-project and event-by-event, not assumed at a regional level.

Force majeure: what it does and doesn't give you

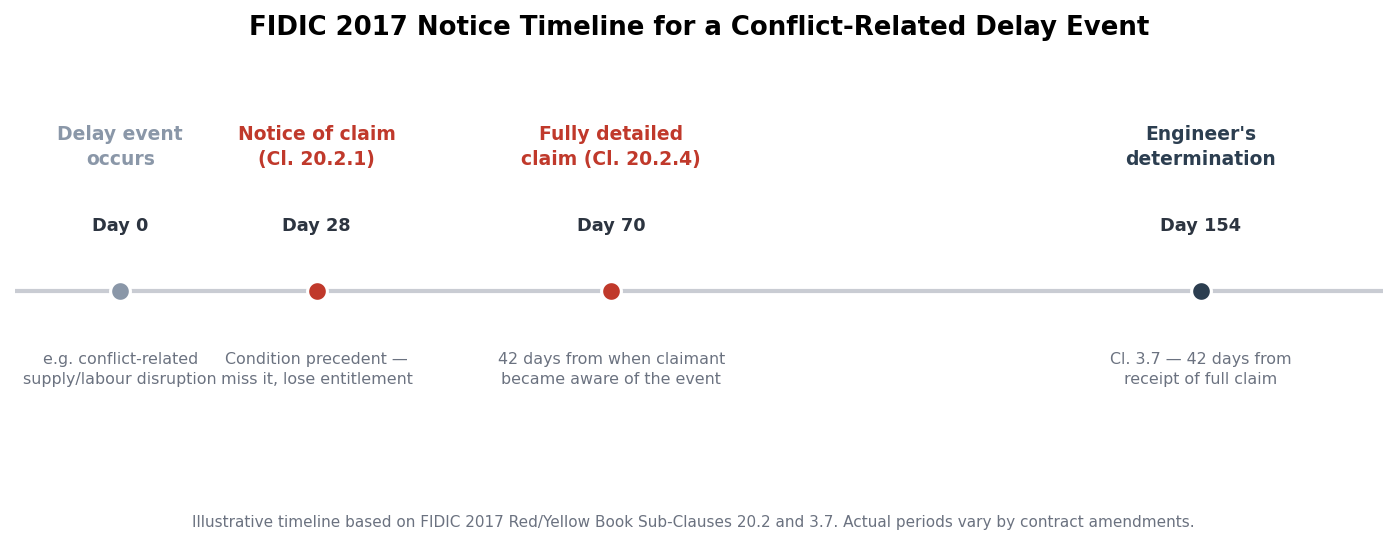

Under FIDIC 2017 (Red, Yellow and Silver Books), an "Exceptional Event" under Sub-Clause 18.1 covers events or circumstances beyond a party's control that could not reasonably have been provided against, and that are not substantially attributable to the other party. War, hostilities, invasion, and acts of foreign enemies are expressly listed examples. Under FIDIC 1999, the equivalent mechanism sits in Clause 19 (Force Majeure), with a near-identical list.

That said, three points are consistently misunderstood by contractors trying to rely on it:
